TL;DR

Choosing a multi system integration partner in 2026 is a strategic decision, not a procurement one. 84% of system integration projects fail or partially fail, 95% of IT leaders say integration issues actively impede AI implementation, and organizations now average 897 applications with only 29% of them integrated.

The right partner determines whether your integration compounds value or quietly stalls at 70% complete. This guide covers the seven attributes to evaluate, the questions to ask during vetting, how to structure the contract, and when a boutique specialist beats a big firm. Read this before you sign anything.

Key Takeaways

  •       84% of system integration projects fail or partially fail, and large scale projects show 50% higher failure rates than incremental approaches (Integrate.io, 2026).
  •       Companies with strong integration achieve 10.3x ROI on AI initiatives versus 3.7x for those with poor connectivity (MuleSoft 2025 Connectivity Benchmark).
  •       The global system integration market is valued at $443 billion in 2025 and projected to hit $1.13 trillion by 2034, at an 11.3% CAGR (Fortune Business Insights, 2025).
  •       The right partner has domain depth in your industry, real platform certifications, a documented architectural point of view, and a security posture that survives a serious audit.
  •       Mid market projects run $150,000 to $750,000 with a specialist partner. Big four firms often quote $600,000 to $2,000,000 for equivalent scope (ConsultingDemand, 2026; ERP Research, 2026).
  •       Structure the contract in phases with go or no go gates, not one giant fixed price. This is the single change that most improves your downside.
  •       The most important vetting question is not what they have delivered. It is how they handle the moment when the plan breaks.

Introduction

If you have led an integration project before, you already know the feeling. The kickoff is optimistic. The first three months move fast. Then something shifts.

Requirements creep. A critical data field turns out to be inconsistent across two source systems. A stakeholder who was quiet during scoping shows up with a hard requirement. By month six, the executive who sponsored the project is asking pointed questions that the delivery team cannot answer cleanly.

Almost every time this pattern shows up, the root cause traces back to a decision made before any code was written. The wrong multi system integration partner was selected, or the right partner was selected but engaged in the wrong shape of contract. Either way, the failure was baked in at signature, not at delivery.

This is the 2026 update to our earlier explainer on how to choose an integration partner. The old version treated the decision as a vendor selection exercise. That framing is outdated. The right way to think about a multi system integration partner today is as the organization that will shape your revenue reporting, AI readiness, security posture, and audit trail for the next five to ten years.

That is a different level of decision, and it deserves a different process. This guide walks through what that process looks like at Mountainise and inside the mid market and enterprise clients we work with.

FAST FACT: 84% of all system integration projects fail or partially fail, and large scale projects show 50% higher failure rates than incremental approaches due to compounding complexity. (Source: Integrate.io, 2026)

What Is Complex Multi System Integration, and Why Does the Partner Matter So Much?

Complex Multi System Integration

Complex multi system integration is the discipline of connecting disparate applications, data stores, and workflows so an organization runs on one coordinated operating flow instead of many disconnected islands. It goes beyond simple API wiring.

A true multi system integration effort typically involves CRM to ERP, marketing automation to finance, product analytics to customer success, identity to compliance, and often legacy on premise systems to cloud native platforms. Each connection carries its own data model, its own governance rules, and its own failure modes.

The partner matters because the technical work is only half the challenge. The rest is governance, sequencing, data modeling, security, and change management. Get one of those wrong and the integration technically works but produces reports nobody trusts. Get two wrong and the project quietly stalls at 70% complete.

That is not hypothetical. 84% of all system integration projects fail or partially fail, and large scale projects show 50% higher failure rates than incremental approaches because complexity compounds faster than most teams plan for.

Organizations today average 897 applications, but only 29% of them are integrated (MuleSoft’s 2025 Connectivity Benchmark). That gap is not going away as AI adoption accelerates. 95% of IT leaders report that integration issues actively impede AI implementation.

So the partner is not just executing a project. They are unlocking (or blocking) the next three years of AI value in your business. That is why who you integrate with is no longer a procurement decision. It is a strategic decision that will shape your revenue, security posture, and AI readiness for the next decade.

What Is the Real Cost of Choosing the Wrong Multi System Integration Partner?

The cost shows up in four places, and only one of them is line item visible on the invoice.

The first is direct project cost. A mid market multi system integration project typically runs $150,000 to $750,000 with a specialist partner. A big four firm on the same scope often lands at $600,000 to $2,000,000 or more due to overhead and staffing structure. That gap alone justifies careful partner selection.

The second is opportunity cost. If the partner delivers late, or delivers something that requires rework, you pay twice: once for the original build, and again for the fix. The average recovery timeline on a partially failed integration is nine to fourteen months, during which your revenue teams operate with the same broken data they had before the project started.

The third is security exposure. IBM’s 2025 Cost of a Data Breach Report puts the average global breach at $4.4 million. Poorly integrated systems create the exact conditions that lead to those breaches: shadow data flows, unmanaged access, and gaps in audit trails.

63% of organizations lack AI governance policies, and 97% of those with AI related incidents lacked proper AI access controls (IBM, 2025). Choose a partner who treats security as an architectural concern, not a compliance checkbox. Our integration consulting team builds security into the data model before writing a single connector.

The fourth is opportunity cost on AI. Companies with strong integration achieve 10.3x ROI on AI initiatives versus 3.7x for those with poor connectivity (MuleSoft, 2025). If you plan to invest in AI over the next 24 months, the integration foundation determines whether those investments compound or evaporate.

What Should You Look For in a Multi System Integration Partner?

Seven attributes separate integration partners who deliver from those who do not.

  •       Domain depth in your industry. A partner who has done ten CRM to ERP integrations in freight or healthcare will finish yours faster and with fewer surprises than one who has not. Ask for reference clients in your vertical, not just similar sized companies.
  •       Platform certifications that match your stack. If you are on Salesforce, HubSpot, NetSuite, or Snowflake, certifications from those vendors are table stakes. Not sufficient, but necessary.
  •       Proof of complex work delivered. Look for case studies with specifics: system count, record volume, downtime tolerance, and before and after cycle times. Vague success stories mean vague delivery.
  •       Architectural point of view. A strong partner will push back on your requirements. If they nod along and quote the exact scope you asked for, they are order takers, not partners. You want someone who will say this integration will fail in year two if we build it the way you described, here is a better sequence.
  •       Security and compliance track record. Ask for SOC 2 status, evidence of HIPAA or PCI experience if applicable, and how they handle production access. If they cannot answer these in the first meeting, walk away.
  •       Delivery model that fits your ops. Some partners deliver, hand off, and leave. Others stay for managed services. Some do everything in a fixed price sprint, others in time and materials. Match the model to your internal capacity and risk profile.
  •       Cultural fit and communication cadence. This sounds soft but breaks more projects than any technical decision. You will be in weekly calls with this team for six to nine months. Make sure the working style matches.

The mistake most buyers make is treating these seven attributes as equally weighted. They are not. Domain depth and architectural point of view carry the most predictive weight for delivery outcomes. Everything else can be coached or contracted around. See our integration case studies for examples of how these attributes play out in practice.

FAST FACT: Companies with strong integration achieve 10.3x ROI from AI initiatives versus 3.7x for those with poor connectivity, and 95% of IT leaders say integration issues actively impede AI implementation. (Source: MuleSoft 2025 Connectivity Benchmark via Integrate.io)

How Do You Evaluate Technical Depth Beyond the Sales Pitch?

Sales cycles reward pattern matching. Every integration partner will use similar language, show similar case study slides, and reference similar platform certifications. The technical depth question is how you separate the real thing from the demo.

Ask to speak with the actual delivery lead, not the account executive. If the partner will not let you talk to the person who will run your project until after signature, that is a signal.

Real specialists are proud to bring their senior architects to a prospect call. If the same three people are on every deal but different names show up on delivery, you are being sold to by an A team and delivered by a B team.

Ask for a design review from a prior project. Not the polished case study, the actual architecture doc. If they cannot share one (redacted is fine), they either did not produce one, produced a bad one, or do not have permission to reuse it. All three are informative.

Give them a hard problem in the first meeting. Not a hypothetical, an actual thorny issue from your environment. See how they think about it out loud. A good architect will ask three clarifying questions before proposing anything. A weak one will jump to a tool recommendation within 90 seconds.

Finally, check the retention of their senior technical staff. Integration expertise takes years to build. If their architects have been in seat less than 18 months, you are hiring a firm that trains people up and loses them to competitors. That churn will show up in your project as inconsistent handoffs and rework.

What Questions Should You Ask During the Evaluation Process?

Twelve questions surface fast. Ask all of them. Note which are answered specifically, which are answered generically, and which are dodged.

  •       What are the three most likely ways this project fails, based on projects you have delivered in the past year?
  •       Walk me through your data governance approach for lineage, auditability, and access control.
  •       How do you handle the moment when the plan breaks?
  •       What percentage of your revenue comes from your top three clients?
  •       Who owns the delivery roadmap: your team, our team, or a shared steering committee, and what is the escalation path?
  •       What does your test coverage look like on integrations that touch financial data?
  •       What are the top three tools you deliberately avoid, and why?
  •       How do you handle knowledge transfer at the end of the engagement so we can maintain what you build?
  •       What is your typical variance on time and budget estimates for a project of this scope?
  •       What SLAs do you offer post go live, and what is your on call response time for a production incident?
  •       Show me a change order from a prior project and walk me through what triggered it and how you scoped the delta.
  •       Which of your team members would work on this engagement, and can I meet them before signing?

The single most revealing answer usually comes from the third question. How a partner handles the moment when the plan breaks tells you almost everything about how the last two months of your project will go. Firms that answer this well have a process. Firms that do not usually improvise, which is expensive.

How Does the Partner Handle Security, Governance, and Risk?

Security is where most integration projects quietly acquire debt. Everyone agrees it matters. Nobody wants to slow the project down for it.

So the partner ships a working integration, the security review is added as a follow up phase, and 18 months later you find out the vendor with production access no longer employs the person who set up the credential.

A strong multi system integration partner treats security as a design constraint from day one. Expect them to insist on an identity model up front, define access control per system, log every data flow, and separate production credentials from dev. If they treat any of these as optional, that is your answer on whether they will show up in an audit.

Ask specifically about how they handle access to your production systems. Do they use your identity provider or their own? Do they rotate credentials automatically or manually? Are their engineers using MFA on every session? Do they log actions to a system you control? These are baseline expectations for any partner touching enterprise data in 2026, and they line up with the standards our Salesforce and CRM implementation team enforces on every engagement.

The governance side matters equally. Your integration will produce reports. Those reports will inform revenue decisions. If the underlying data lineage is unclear, the CFO will not trust the numbers, and the entire investment loses its ROI.

Ask the partner how they document lineage, how they version data models, and how they handle the moment a downstream field changes and every dependent report needs to be re certified. If they do not have a specific answer, they will figure it out on your project. That is expensive.

FAST FACT: The average global data breach cost hit $4.4 million in 2025, and 63% of organizations lacked AI governance policies. Integration without governance creates costly exposure. (Source: IBM 2025 Cost of a Data Breach Report via TheHubOps)

What Does a Modern Integration Engagement Look Like in 2026?

Modern Integration Engagement

The engagement model has shifted meaningfully in the last three years. The old pattern was: sign a fixed price statement of work, run a nine month waterfall, deliver a big bang cutover.

That model still exists at big firms, but it produces the exact failure modes that push failure rates above 80% (Integrate.io, 2026).

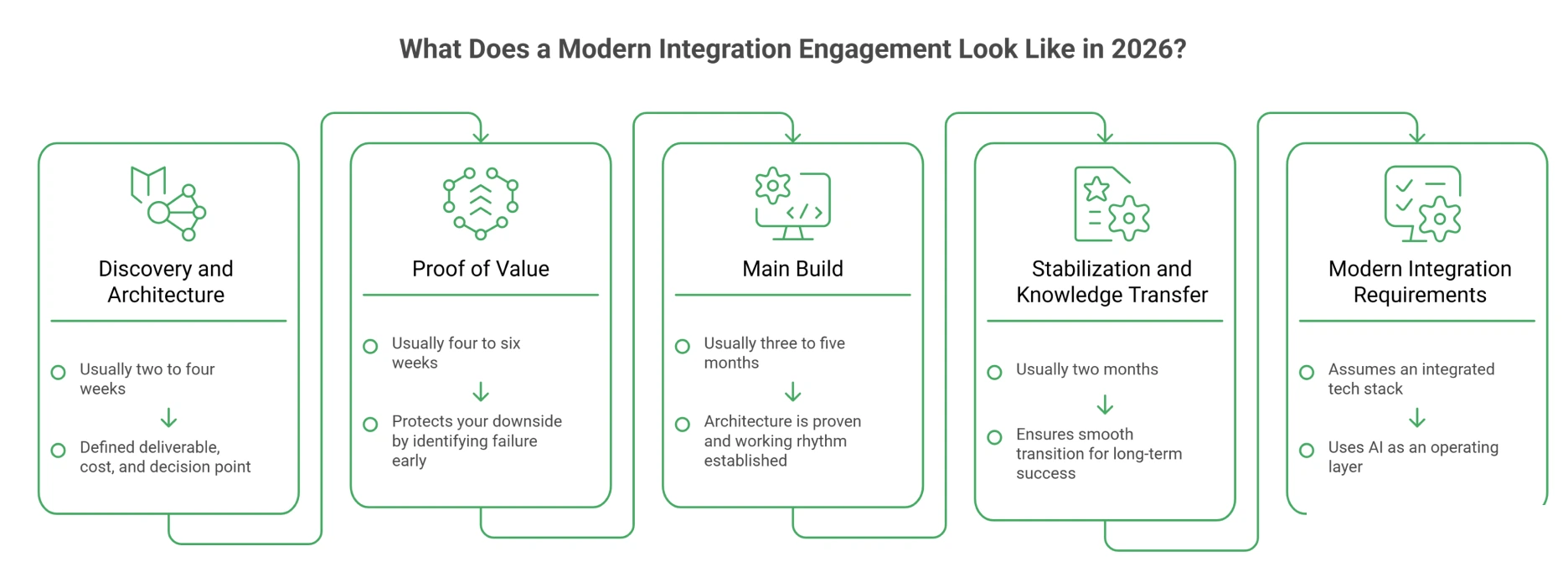

The 2026 model looks different. It runs in four phases with go or no go gates between each. Phase one is discovery and architecture, usually two to four weeks. Phase two is a proof of value on the highest risk integration in the scope, usually four to six weeks. Phase three is the main build, usually three to five months. Phase four is stabilization and knowledge transfer, usually two months.

Every phase has a defined deliverable, a defined cost, and a defined decision point where either party can pause or exit. This phased structure is what protects your downside.

If the partner is going to fail, you find out in phase one or phase two, when you have spent $30,000 to $80,000 rather than $500,000. If the partner is going to succeed, phases three and four run smoothly because the architecture is proven and the working rhythm is established. The 2026 engagement model also assumes an integrated tech stack rather than a series of isolated point to point connectors.

The engagement also assumes AI as an operating layer, not a future project. Modern integrations use AI for schema mapping, exception handling, and anomaly detection during data flow. If your partner is quoting a project that treats AI as a separate phase 18 months from now, they are behind the market.

How Should You Structure the Contract to Protect Your Downside?

Four contract structures reliably reduce project risk.

Structure the engagement in phases with independent scopes and prices. Do not sign one fixed price contract for the entire integration. Sign a series of smaller ones with clear go or no go gates. This single change reduces your worst case exposure by 60 to 80% and gives you real leverage to address issues before they compound.

Include a source code and documentation clause. Every artifact produced during the engagement, including architecture diagrams, integration mappings, deployment scripts, and test plans, is your property and delivered in an editable format to a repository you control. Some partners resist this. That resistance is the answer to whether you want them building anything you will need to maintain.

Define acceptance criteria per phase, not per deliverable. Acceptance should be tied to outcomes (data reconciles across systems within a defined tolerance, reports produce the same total as source system) rather than artifacts (documentation submitted). Outcome based acceptance forces the partner to solve the actual problem, not to check boxes.

Cap change orders as a percentage of phase cost. Scope creep is where budgets go to die. A reasonable change order cap is 15% of the phase price before requiring a formal replanning session. This does not prevent legitimate scope additions. It prevents small ones from accumulating into a 40% overrun that nobody explicitly approved.

When Should You Choose a Boutique Partner Over a Big Firm?

Both models have legitimate use cases. The choice depends on scope, timeline, internal capacity, and the political weight the decision needs to carry.

Choose a boutique specialist when the scope is well defined, the domain is specialized (RevOps, healthcare interoperability, freight and logistics), the internal team can absorb knowledge transfer, the budget is under $750,000, and the timeline is under nine months.

In these conditions, boutiques deliver faster with more senior talent per dollar. The trade off is less resiliency: if the two engineers assigned to your project leave the firm, you feel it.

Choose a big firm when the scope spans multiple geographies, the program is expected to run 18 months or longer, the political dynamics require a name brand for board optics, the internal team is stretched and needs a large delivery team, or the integration is one part of a larger transformation that already involves that firm. Big firm engagements often cross $3 million for broader transformation work (ConsultingDemand, 2026), which is worth the cost when scale demands continuity, and painful when it does not.

Big firms deliver more consistency and continuity. The trade off is cost, senior talent dilution, and slower decision cycles.

The middle path many mid market companies take is a boutique specialist as the technical lead, with a big firm running program management or change management around the integration. This gives you the delivery depth of a specialist with the organizational muscle of the larger firm. If you want to talk through which model fits your situation, book a strategy session with the Mountainise team.

Summary

Choosing the right multi system integration partner in 2026 is a strategic decision that shapes your revenue reporting, AI readiness, security posture, and audit trail for the next five to ten years. 84% of integration projects fail or partially fail, and the partner you select is the single largest predictor of which side of that number you land on. The seven attributes that matter are domain depth in your industry, real platform certifications, proof of complex delivery, an architectural point of view, security and compliance track record, a delivery model that matches your ops, and cultural fit.

The single most important structural decision is the shape of the contract, not the price of it. Phased engagements with go or no go gates reduce your worst case exposure by 60 to 80% versus a single fixed price contract. Source code ownership, outcome based acceptance criteria, and capped change orders are the other three levers. Boutique specialists win on speed and senior talent per dollar for scopes under $750,000. Big firms win on continuity and consistency at scale. The middle path (a boutique technical lead with a big firm running program management) is the fit for many mid market integrations that need both.

Ready to Choose Your Integration Partner?

If you are evaluating a multi system integration partner and want a second opinion on scope, contract structure, or partner shortlist, book a strategy session with the Mountainise team. We will walk you through our vetting framework, share what we would ask each candidate, and help you structure the engagement so your worst case is small and your best case is compounding.

Frequently Asked Questions

How long does a complex multi system integration project typically take?

A typical mid market multi system integration project runs six to twelve months from kickoff to production stabilization. Discovery and architecture take four to eight weeks, a proof of value integration takes another four to six weeks, the main build takes three to five months, and stabilization takes another two months. Timelines above twelve months usually indicate scope that should have been split into two phased programs.

What is the difference between an integration partner and a systems integrator?

Systems integrators traditionally focus on infrastructure and platform level integration such as connecting networks, servers, and enterprise applications end to end. Integration partners in the 2026 sense also cover data, workflow, and process integration across CRM, marketing, finance, and product platforms, with a stronger focus on business outcomes than infrastructure. Many boutique multi system integration partners do both. Large firms tend to specialize in one or the other and partner for the rest.

What is iPaaS, and does the partner need to specialize in one platform?

iPaaS stands for integration platform as a service. It is cloud native middleware used to connect applications and automate data flows. iPaaS accounts for 33.10% of the enterprise application integration market in 2025 (Mordor Intelligence, 2026). Common platforms include MuleSoft, Boomi, Workato, and Celigo. A capable partner should have deep experience in at least one iPaaS aligned with your stack, but you do not want a partner who only knows one tool. Tool independence is a signal of maturity.

Should we insource or outsource complex system integration?

The answer depends on how repeatable the work is. If your organization will run integration projects continuously (typical of large enterprises), building an internal integration center of excellence makes sense. If integrations are periodic (one every 12 to 24 months at mid market scale), outsourcing to a specialist partner delivers better cost and outcome than staffing an internal team that will spend most of its time under utilized.

How do I know if an integration project is starting to fail?

Six leading indicators show up before the timeline slips. Repeated mapping changes, unclear ownership on issues raised in status meetings, growing manual reconciliation between systems, unstable test data, duplicate APIs for the same purpose, and reporting mismatches during UAT. If two or more of these appear in the same week, escalate. If four or more appear in the same month, the project is already in trouble even if the RAG status is still green (TheHubOps, 2026).

What is the typical cost of a complex multi system integration project?

Ranges depend on scope and partner type. A focused three to four system integration with a boutique specialist runs $150,000 to $350,000. A broader six to eight system program runs $400,000 to $900,000. Enterprise scale programs with change management, program office, and multi region rollout can exceed $1,500,000. Big four firms typically quote two to three times the equivalent boutique price (ERP Research, 2026). Ongoing managed services after go live usually run $8,000 to $25,000 per month depending on complexity.

How do I structure a contract with an integration partner to protect our downside?

Structure the engagement in phases with independent scopes and prices, include a source code and documentation clause that transfers all artifacts to your control, define acceptance criteria based on outcomes rather than deliverables, and cap change orders at 15% of phase cost before requiring formal replanning. This structure gives you real leverage at each go or no go gate and dramatically reduces worst case exposure compared to a single fixed price contract.
